Work Orders, BOM & Routing

A Work Order (WO) is an instruction to either manufacture a finished good or transfer stock between locations. It is the engine of the Operations module: it explodes a BOM against a build quantity, sequences a routing, draws material from stores, drives the shop floor, and rolls every rupee of material and conversion into a per-unit cost. This page works one manufacturing order end to end.

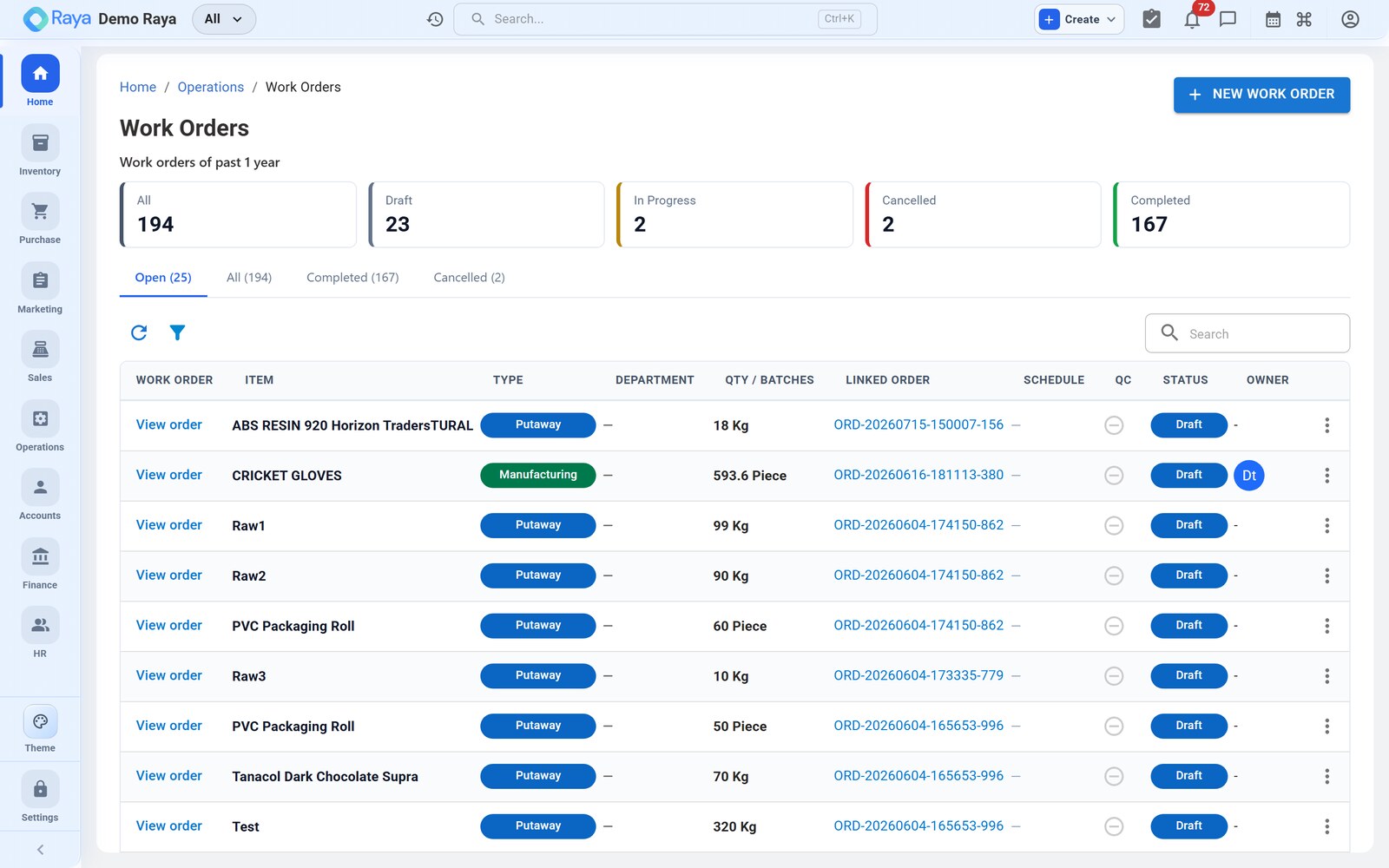

Work orders list

Worked scenario — WO-2418: build 2,000 × 50 L HDPE Drum

The Produce allocation on SO-1290 raised WO-2418. Its master data:

FieldValue
TypeManufacturing
Finished item50 L HDPE Drum (Finished Goods, HSN 3923)
Quantity to produce2,000
From locationRaw Material Stores
To locationFinished Goods — Warehouse A
Due date12 days out
Standard cost₹214 / drum → WO value ₹4,28,000

Everything below scales this recipe by 2,000 and tracks it to completion.

Work order types

  • Manufacturing — make a finished good from its raw materials (the focus of this page).
  • Internal Transfer — move an item from one location to another (covered at the end).

The BOM behind the drum

A Bill of Materials is the recipe for one finished unit, including a per-component scrap %. WO-2418 loads this automatically:

ComponentQty / drumScrap %RateCost / drum
HDPE Granules Grade A2.4 kg1.2%₹80/kg₹192.00
Masterbatch Blue40 g1.2%₹250/kg₹10.00
Lid + gasket set1₹6.00₹6.00
Material / drum₹208.00

The routing (process steps)

A routing defines the ordered operations — with work centre/machine, setup time and cycle time — used to sequence and cost production. The drum's routing:

SeqOperationWork centreSetupCycle / drumConversion / drum
10ExtrusionExtruder EX-230 min22 s₹1.20
20Blow mouldingBlow moulder BM-120 min35 s₹1.30
30TrimmingTrim station TR-110 min12 s₹0.40
40PackingPack bench PK-15 min15 s₹0.60
Conversion / drum₹3.50

Per-unit standard cost rollup

Material + scrap allowance + conversion gives the standard cost the work order is valued at:

ElementAmount / drum
Direct material (2.4 kg HDPE + 40 g masterbatch + lid)₹208.00
Scrap allowance @ 1.2% of material₹2.50
Conversion (routing labour + machine overhead)₹3.50
Standard cost / drum₹214.00
× 2,000 drums = work order standard value₹4,28,000

Create a manufacturing work order

Go to Operations → Work Orders → + New Work Order and set:

  1. Type — Manufacturing.
  2. Finished Item — the 50 L HDPE Drum (must be Finished Goods with a BOM).
  3. Quantity to produce — 2,000.
  4. From Location — Raw Material Stores (where components sit).
  5. To Location — Finished Goods — Warehouse A (where drums land).
  6. Due date, and optional priority.

The BOM loads automatically — each component × 2,000, grossed up for scrap — and can be adjusted for this one order (e.g. a temporary substitute granule) without touching the master BOM. The routing comes with the item if it has one.

Work order lifecycle

Draft → Released → In Progress → QC → Completed
(or Cancelled)
StatusWhat happens
DraftBeing prepared; nothing reserved yet. Edit BOM/routing freely.
ReleasedRaw materials are reserved in stores. In Advanced, releasing generates job cards — one per routing step.
In ProgressProduction is live. Operators log actual quantities consumed and scrap (with a reason). Materials are deducted (Manufacturing Consumption).
QCOutput is routed to Quality Control.
CompletedFinished goods are added to the To Location (Manufacturing Output).

Releasing to the shop floor

Releasing WO-2418 reserves its materials and, under Advanced Manufacturing, breaks the order into job cards — one per routing step, in sequence. The reserved material picture:

ComponentPer drum× 2,000 + scrapRateReserved value
HDPE Granules Grade A2.4 kg4,857.6 kg₹80/kg₹3,88,608
Masterbatch Blue40 g80.96 kg₹250/kg₹20,240
Lid + gasket set12,024₹6₹12,144
Total reserved₹4,20,992

:::note Advanced only Multi-level work-order trees (sub-assemblies feeding an assembly feeding the finished good) and job cards require Advanced Manufacturing in Settings → Feature flags. On the Standard tier a work order is single-level: you record consumption and output on the order itself without per-step job cards. :::

Stage-wise progress on the job cards

Operators clear the four job cards in order, logging pass/fail counts and machine time as they go. A snapshot mid-run:

Job cardOperationDoneScrap loggedReason
JC-01Extrusion2,02412Off-cut / purge
JC-02Blow moulding2,0128Short shot
JC-03Trimming2,0044Flash reject
JC-04Packing2,000

Each cleared job card posts its updates straight to stock and costing — you never re-key the numbers into the ledger.

Material issue and backflush

There are two ways components leave stores:

  • Issue — the storekeeper explicitly issues components against the released work order (good when material is drawn in stages).
  • Backflush — components are consumed automatically in BOM proportion the moment output is confirmed at a step, so the operator never files a separate issue slip.

When WO-2418 goes In Progress, the actual consumption is recorded (here backflushed per the granules the moulders actually drew):

ComponentPlanned (with scrap)Actual consumedRateActual value
HDPE Granules Grade A4,857.6 kg4,872 kg₹80/kg₹3,89,760
Masterbatch Blue80.96 kg81 kg₹250/kg₹20,250
Lid + gasket set2,0242,020₹6₹12,120
Actual material₹4,22,130

The gap between actual (₹4,22,130) and planned (₹4,20,992) is a material usage variance of ₹1,138 (unfavourable) — the moulders ran slightly hot on granules. Raya surfaces this in the costing rollup rather than hiding it in the finished-goods value.

:::caution Log scrap with a reason Every scrap unit must carry a reason (defective, off-cut, purge, evaporation). Scrap is posted as an Adjustment Decrease against stock, keeping material variance visible in the stock movement report — don't bury a bad run by inflating "consumed". :::

Stock and costing effects

EventStock moveEffect
ReleasedReservation₹4,20,992 of raw material committed (not yet deducted).
In ProgressManufacturing ConsumptionRaw material −₹4,22,130 from stores.
Scrap loggedAdjustment DecreaseScrapped material written off, with reason.
CompletedManufacturing Output2,000 drums added to Finished Goods at the rolled-up build cost, updating the drum's weighted-average cost.

Actual rollup for the batch:

Actual material consumed .......... ₹4,22,130
Conversion applied (2,000 × ₹3.50) ₹7,000
---------
Actual build cost ................. ₹4,29,130
Good units ........................ 2,000
Actual cost / drum ................ ₹214.57 (vs standard ₹214.00)

The ₹0.57/drum difference (₹1,130 across the batch) is the production variance.

:::note COGS comes later, at dispatch Completing the work order only moves inventory (raw material out, finished goods in) — it does not post COGS. The P&L hit happens when the drums ship: the delivery order posts the Sales and COGS vouchers. Until then the drums sit in finished-goods stock at ₹214/unit. :::

Internal transfer work orders

Simpler than manufacturing: set Type = Internal Transfer, pick the item, quantity, From and To locations, and a due date. There is no BOM or routing. On Released a Transfer Out entry leaves the source; on Completed a Transfer In entry lands the stock at the destination — for example moving the finished drums from Warehouse A to a dispatch dock closer to the loading bay.
